100% independent. Rythium takes no fees, commissions or partnerships from any software or AI vendor. Ever.

IBM Sub-Capacity Licensing and the ILMT Tool: What Auditors Check

Sub-capacity licensing lets you pay for only the cores your IBM software can use, not the whole server. IBM’s own example: WebSphere on 8 of 16 cores costs $16,800 against $33,600 at full capacity (illustrative figures at 70 PVUs per core and $30 per PVU). That saving is conditional, and in an audit the burden is on you to prove the conditions were met. The proof IBM accepts comes from the IBM License Metric Tool (ILMT) or one of the other approved tools below.

What IBM requires for sub-capacity licensing

  • An approved tool. ILMT, HCL BigFix Inventory, or IBM’s pre-approved Flexera One products where they support your virtualization technology. IBM stopped accepting exceptions to this on May 1, 2023.
  • Timing. New sub-capacity customers must implement ILMT within 90 days of the first eligible deployment.
  • Reporting. Reports at least quarterly, kept for two years and provided to IBM or its auditors on request.
  • Currency. ILMT is updated quarterly, and IBM says you must keep it current.
  • Peak counting. IBM counts the high-water mark. There is no averaging and no grace period.

If the conditions are not met, the affected programs are licensed at full capacity.

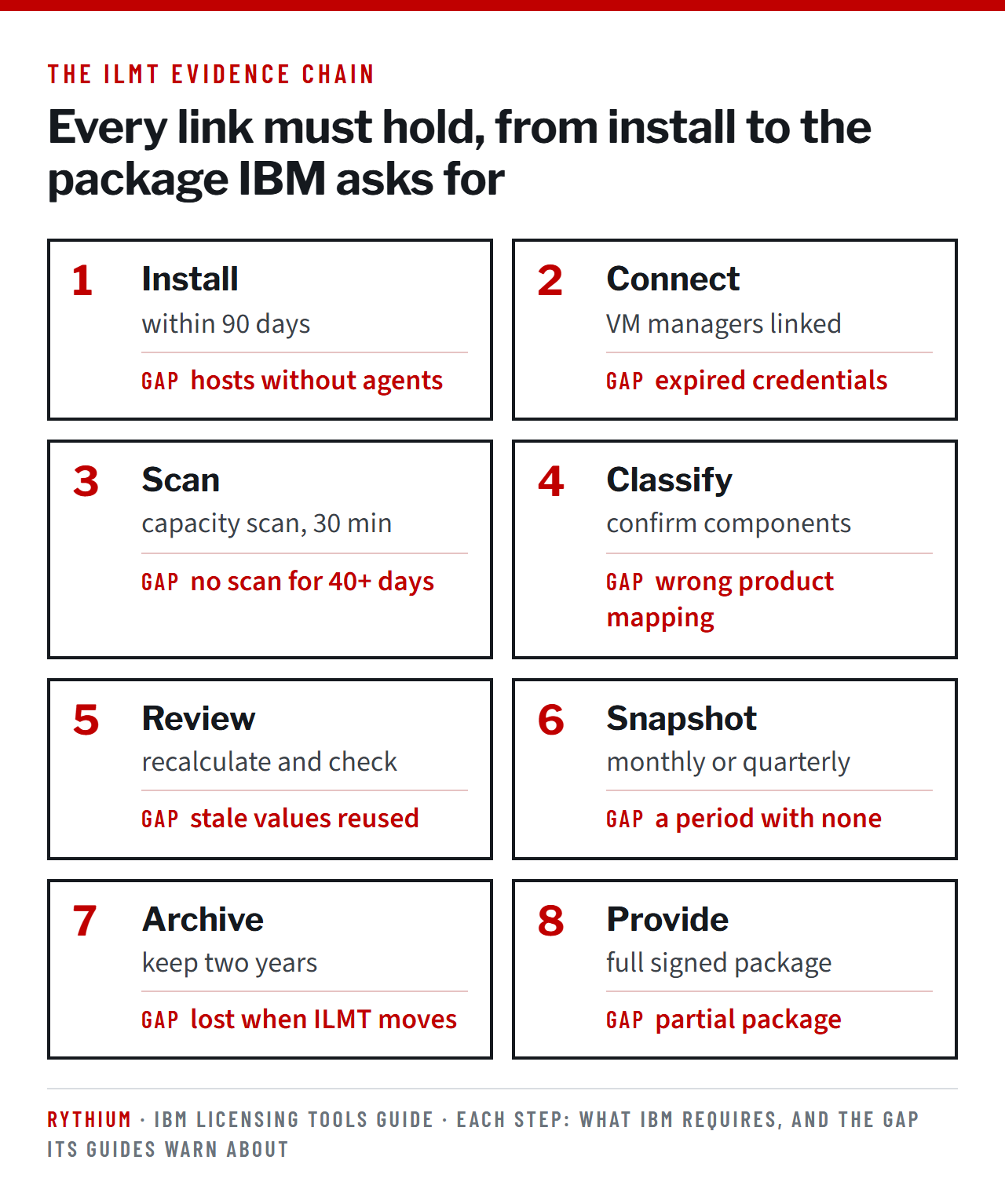

The ILMT evidence chain in eight steps: install within 90 days, connect VM managers, scan, classify, review, snapshot, archive for two years and provide the full signed package, each with the gap IBM's guides warn about.

The five checks

  • Coverage. A scanner must run on every machine with IBM software you want counted, including non-production. Compare the ILMT computer list with your hypervisor inventory or CMDB to find gaps.
  • VM manager connections. Without them, ILMT falls back to default counting: it counts each VM’s cores at 120 PVUs per core and cannot cap the count at the host’s physical capacity. IBM still accepts a report calculated this way. In IBM’s own example (a 16-core host with VMs of 12 and 10 cores, IBM MQ on both, $50 per PVU), that raises the bill from $56,000 to $132,000 (see the figure below). Check the VM Managers panel for failed connections and expired credentials. An outdated status that stays unresolved for 30 days (the default) becomes “No VM Manager Data”.
  • Scan health. Capacity scans run every 30 minutes and software scans weekly by default. ILMT flags a computer as “Missing Scan” when its last successful software scan is over 40 days old (defaults for ILMT 9.2.x; check your version).
  • Software classification. ILMT’s automatic mapping must be reviewed. Import your entitled part numbers, assign bundled and supporting programs correctly, map Cloud Pak components, and comment every exclusion.
  • Audit snapshots and archive. Generate a signed snapshot from the All Metrics or PVU Sub-Capacity report. Quarterly is the maximum interval; ILMT defaults to monthly. Keep each snapshot for two years, supply it in full, and store it somewhere other than the ILMT server.

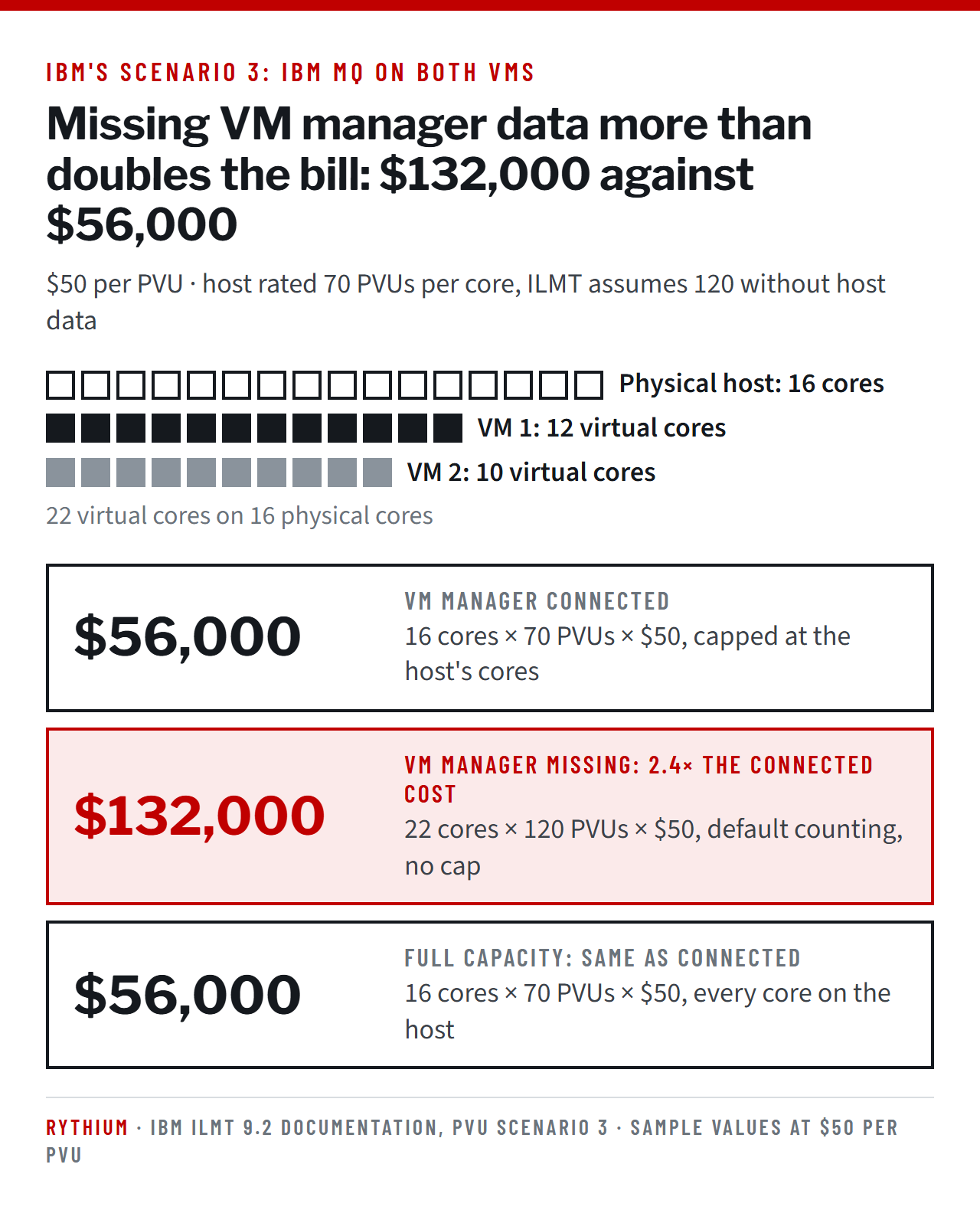

IBM MQ on a 16-core host with two VMs of 12 and 10 virtual cores at $50 per PVU: $56,000 with the VM manager connected, $132,000 with it missing, and $56,000 at full capacity.

The figure reproduces IBM’s Scenario 3: a 16-core host with two VMs of 12 and 10 virtual cores, both running IBM MQ. Together the VMs have 22 virtual cores, more than the host’s 16 physical cores.

  • VM manager connected. ILMT knows the host, so it uses the processor’s real rating (70 PVUs per core) and caps the count at the host’s 16 physical cores: 16 × 70 = 1,120 PVUs, or $56,000.
  • VM manager missing. ILMT sees only the processor model and each VM’s virtual cores. It cannot cap the count, so it counts all 22 cores, and it assumes the highest rating for that processor, 120 PVUs per core: 22 × 120 = 2,640 PVUs, or $132,000. IBM says it accepts audit reports calculated this way rather than treating the client as ineligible for sub-capacity.
  • Full capacity. The product is licensed on every core of the physical host: 16 × 70 = 1,120 PVUs, or $56,000. IBM’s table shows this figure in its full-capacity column.

In this example full capacity and capped sub-capacity cost the same, because the VMs together have more cores than the host. IBM’s documentation says you acquire licenses for the lower of the sub-capacity and full-capacity values. The 70 and 120 PVU ratings and the $50 price are IBM’s sample values for a two-socket Xeon 3400 server; your rating depends on your processor model.

Newer rules to know

  • Containers. IBM License Service is the only accepted tool, with quarterly snapshots kept for two years. Hybrid estates need both ILMT and License Service.
  • Public cloud. Flag machines so ILMT applies 70 PVUs per vCPU. Otherwise it applies 120.

Stay audit-ready

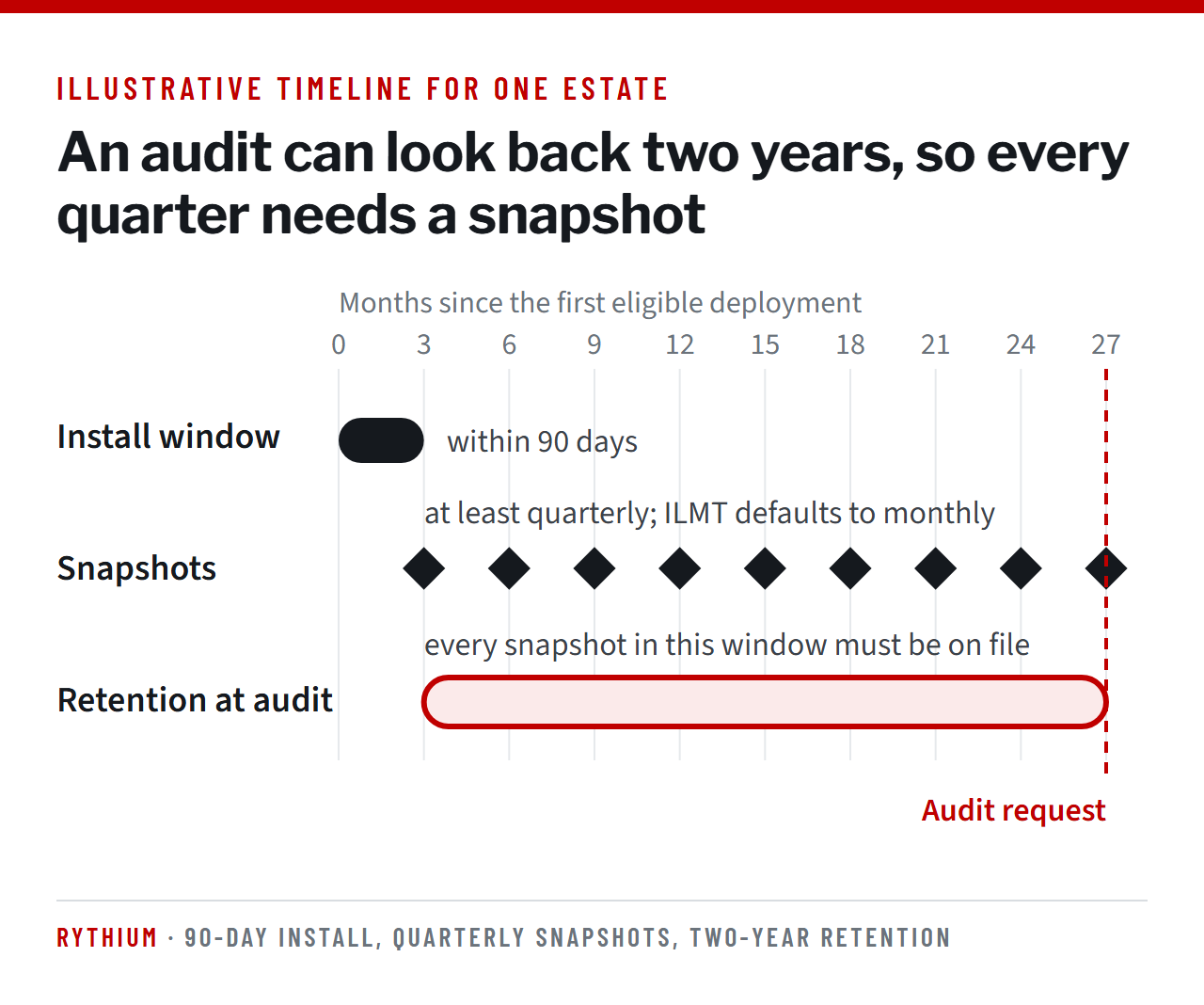

An illustrative timeline for one estate: ILMT installed within 90 days of the first eligible deployment, a snapshot at least every quarter, and every snapshot in the two years before an audit request kept on file.
When What
Weekly Check scan health widgets, VM manager status and import history
Monthly Generate and review the report and an audit snapshot
Quarterly Sign off, archive, update ILMT, reconcile agents against inventory
On change Add agents for new hosts; archive snapshots before decommissioning a server, cluster or ILMT instance

Name one owner for the process. IBM’s FAQ is clear that you can delegate the work but not the responsibility. If no one in-house can own it, our software asset management services run these checks on the same schedule.

Facing an IBM audit notice, or cleaning up an aging ILMT deployment? Fixing gaps before a notice arrives is far cheaper than defending them afterwards. Contact our team to review your ILMT evidence trail.

General information, not legal advice. Your IPAA or IPAEA, product License Information documents and any enterprise agreement govern your terms.

Sources: IBM’s published terms, guides and ILMT documentation, including IBM Passport Advantage sub-capacity licensing, IBM’s counting rules for virtualization technologies, the IBM Licensing Tools guide and the IBM License Metric Tool 9.2 documentation (PVU Scenario 3).
